Project Budgeting: Why Your Estimates Don’t Match Real Logged Hours
One of the most common problems hurting margins in agencies and service-based teams is inaccurate project budgeting. When time estimates are built on assumptions, exclude recurring operational work, or are not compared with logged hours in real time, teams lose visibility and overruns become harder to prevent. This guide explains how to use historical data, track budget variance, and build project budgets that better reflect real delivery.
💡 Quick Summary
- Project budgeting is the process of estimating, allocating, and monitoring the time and resources required to complete a project.
- Project budgets often fail because of four common process gaps: intuition-based estimates, disconnected planning and tracking systems, missing micro-tasks, and delayed visibility into budget consumption.
- Teams can measure estimation accuracy with the budget variance formula: Budget Variance = Estimated Hours − Actual Logged Hours
- A negative result means the project exceeded its estimated hours, while a positive result means it used fewer hours than planned.
- A more reliable project budgeting process follows three steps:
- Audit comparable completed projects
- Monitor burn rate against delivery progress
- Use post-project findings to improve the next estimate.
Project Budgeting Guide: Causes, Variance, and Solutions
- What Is Project Budgeting?
- Why Do Project Estimates Mismatch Real Logged Hours?
- 4 Reasons Why Project Budgeting Fails to Match Real Logged Hours
- How to Calculate Budget Variance From Logged Hours
- Budget Variance vs. Burn Rate: What Is the Difference?
- How to Build More Accurate Project Budgets With Logged-Hour Data
- Industry Benchmark
- How TrackingTime Helps Teams Build More Accurate Project Budgets
- Common Project Budgeting Mistakes
- Turn Project Budgeting Into a Continuous Learning System
What Is Project Budgeting?
Project budgeting is the process of estimating, allocating, and monitoring the time and resources required to complete a project. It typically includes expected hours, project phases and tasks, role allocation, direct costs, contingency, and the rules to track performance during delivery.
For service-based teams, project budgets are often built around hours first. Every additional hour affects project margin, which is why planned hours should be compared with real logged hours throughout the project, not only after it ends.
Key Project Budgeting Terms
📝 Project estimate: The expected time and effort required to complete the work.
📊 Project budget: Total time, capacity, and financial resources the project can consume.
⏱️ Logged hours: The actual time recorded while the work is being delivered.
💰 Project profitability: The financial return left after project costs are deducted.
💡 How to calculate project profitability for agencies
Read our guide on how to calculate project margins, identify where costs accumulate, and track profitability, whether you use a spreadsheet, a finance system, or time tracking software.
Why Do Project Estimates Mismatch Real Logged Hours?
Project estimates mismatch real logged hours when scopes rely on intuition, overlook recurring operational work, remain disconnected from live time data, or are reviewed only after the budget has already been consumed.
In most cases, the gap is not caused by a single unexpected event. It reflects a broken estimation process: the project was scoped from memory, invisible work was left out, and actual hours were not compared with the budget early enough to correct course.
Quick Diagnosis Table
| Symptom | Likely Process Failure |
|---|---|
| Every similar project overruns | Estimates rely on memory instead of historical logs |
| The budget looks healthy until late delivery | Estimated and logged hours are not compared in real time |
| Meetings and revisions consume unexpected time | Recurring micro-tasks were excluded from the scope |
| Final hours vary widely between project managers | There is no shared estimation baseline |
| Projects finish on time but still exceed the budget | Delivery speed is being confused with budget efficiency |
4 Reasons Why Project Budgeting Fails to Match Real Logged Hours
These four process failures explain why planned hours drift away from real logged hours and why teams often detect the problem only after the budget has already been consumed.
1. The Intuition Trap: Estimating From Memory Instead of Historical Data
Estimating from memory tends to prioritize visible production work while overlooking coordination, revisions, client feedback, QA, project management, and handoffs.
The problem becomes worse when a project is labeled “similar to a previous one” without comparing its actual scope, complexity, stakeholder count, or team composition. As a result, each project manager creates a different baseline, and the same estimation mistakes repeat across projects.
Example
A website redesign may be estimated at 110 hours because a previous project took “about three weeks.” Historical time logs may tell a different story:
🎨 Design and development: 70 hours
🗂️ Project management: 18 hours
💬 Client meetings: 14 hours
🔄 Revisions: 12 hours
✅ QA and handoff: 10 hours
Total actual time: 124 hours—before adding contingency.
2. The Static Budget Silo: Planning in One System and Tracking in Another
A project budget often starts in a proposal, spreadsheet, or planning document, while actual time entries accumulate in a separate tracking system. When those two data sources are not connected, the project manager has no reliable way to compare estimated and logged hours as delivery progresses.
Manual reconciliation quickly creates delays, conflicting versions, and uncertainty about how much budget remains. The issue is not using a spreadsheet to create the estimate; it is allowing that estimate to stay static while actual hours continue to accumulate elsewhere.
Diagnostic questions:
- Can the project manager see estimated and logged hours in the same view?
- How often is the budget updated with actual time data?
- Is there one authoritative version of the budget?
- Can the team see remaining hours by phase or task?
3. Granularity Gaps: The Micro-Tasks Missing From the Estimate
Project budgets usually overlook the smaller operational tasks required to complete them. These activities may seem minor in isolation, yet together they can add dozens of unplanned hours to a project.
Commonly omitted work includes internal reviews, client calls, brief clarification, revisions, QA, file preparation, handoffs, reporting, stakeholder coordination, project management, and rework caused by incomplete feedback.
This is where time estimation often breaks down: the scope reflects what the client receives, while logged hours capture everything the team had to do to produce it.
| High-Level Scope Item | Commonly Missing Work |
|---|---|
| Design a homepage | Internal review, client feedback, revisions, asset preparation |
| Develop a feature | Technical planning, QA, fixes, deployment, handoff |
| Produce a campaign | Briefing, meetings, approvals, reporting |
| Write content | Research, SME review, editing, CMS upload |
| Deliver a strategy | Workshops, stakeholder alignment, documentation |
4. Delayed Burn Rate Visibility: Detecting the Overrun Too Late
Reviewing the budget only at the end of the month turns reporting into an autopsy rather than a control system. By the time the final totals reveal the problem, the team may have already consumed too many hours to adjust staffing, reduce scope, or reset client expectations.
A project can use 70% of its estimated hours while only 50% of the scope is complete. That gap is an early warning that the team is consuming budget faster than it is delivering work.
Monitoring this relationship during delivery allows the project manager to reforecast the remaining work and intervene before the overrun becomes irreversible.
👉 Diagnostic action
Review project pace every week using:
- Percentage of the timeline elapsed
- Percentage of estimated hours consumed
- Percentage of deliverables completed
- Forecasted hours required to finish the remaining work
How to Calculate Budget Variance From Logged Hours
Budget variance measures the difference between the hours estimated for a project and the hours actually logged during delivery. It helps project managers see whether the original time estimate was accurate and identify where the project consumed more or fewer hours than planned.
Budget Variance Calculator
Budget Variance (BV) = Estimated Hours − Actual Logged Hours
Also calculates: Budget Variance % — useful for comparing projects of different sizes
Enter estimated and actual hours above to calculate budget variance.
Example
A project was estimated at 160 hours, but the team logged 188 hours.
Budget Variance (BV) = Estimated Hours − Actual Logged Hours
Budget Variance = 160 − 188
Budget Variance = −28 hours
The negative result means the project ran 28 hours over budget.
Budget Variance % = (Estimated Hours − Actual Logged Hours) ÷ Estimated Hours × 100
(160 − 188) ÷ 160 × 100 = −17.5%
This means the project consumed 17.5% more hours than estimated.
Budget variance should also be reviewed by phase, task category, and, when useful, by role. A project may finish close to its total estimate while still hiding major overruns in one phase and unused capacity in another.
| Level | Estimated | Actual | Variance | What It Reveals |
|---|---|---|---|---|
| Total project | 160 h | 188 h | −28 h | Overall overrun |
| Strategy | 20 h | 18 h | +2 h | Under budget |
| Design | 55 h | 72 h | −17 h | Main variance source |
| Development | 65 h | 70 h | −5 h | Moderate overrun |
| QA and handoff | 20 h | 28 h | −8 h | Underestimated closing work |
Budget Variance vs. Burn Rate: What Is the Difference?
Budget variance shows the gap between estimated and actual hours. Burn rate shows how quickly a project is consuming its available budget over time.
The two metrics answer different questions. Budget variance helps teams evaluate estimation accuracy, while burn rate helps managers detect risk during delivery. A project may still show a small variance early on but have an unhealthy burn rate if hours are being consumed faster than work is being completed.
Managers should also monitor remaining hours and completion percentage alongside both metrics. Remaining hours show how much capacity is left, while completion percentage reveals whether budget consumption is keeping pace with actual delivery.
💡 Visibility only works when someone owns the response
Teams should define who reviews budget signals, who can adjust staffing or priorities, and when a client conversation is required. Without clear ownership, early warnings may still go unanswered.
How to Build More Accurate Project Budgets With Logged-Hour Data
A clear, repeatable project budgeting method should work as a continuous learning cycle. Historical data informs the initial budget, active monitoring reveals whether delivery is drifting, and post-project analysis improves the next estimate.
👉 Historical data → Active monitoring → Post-project learning → Better next estimate

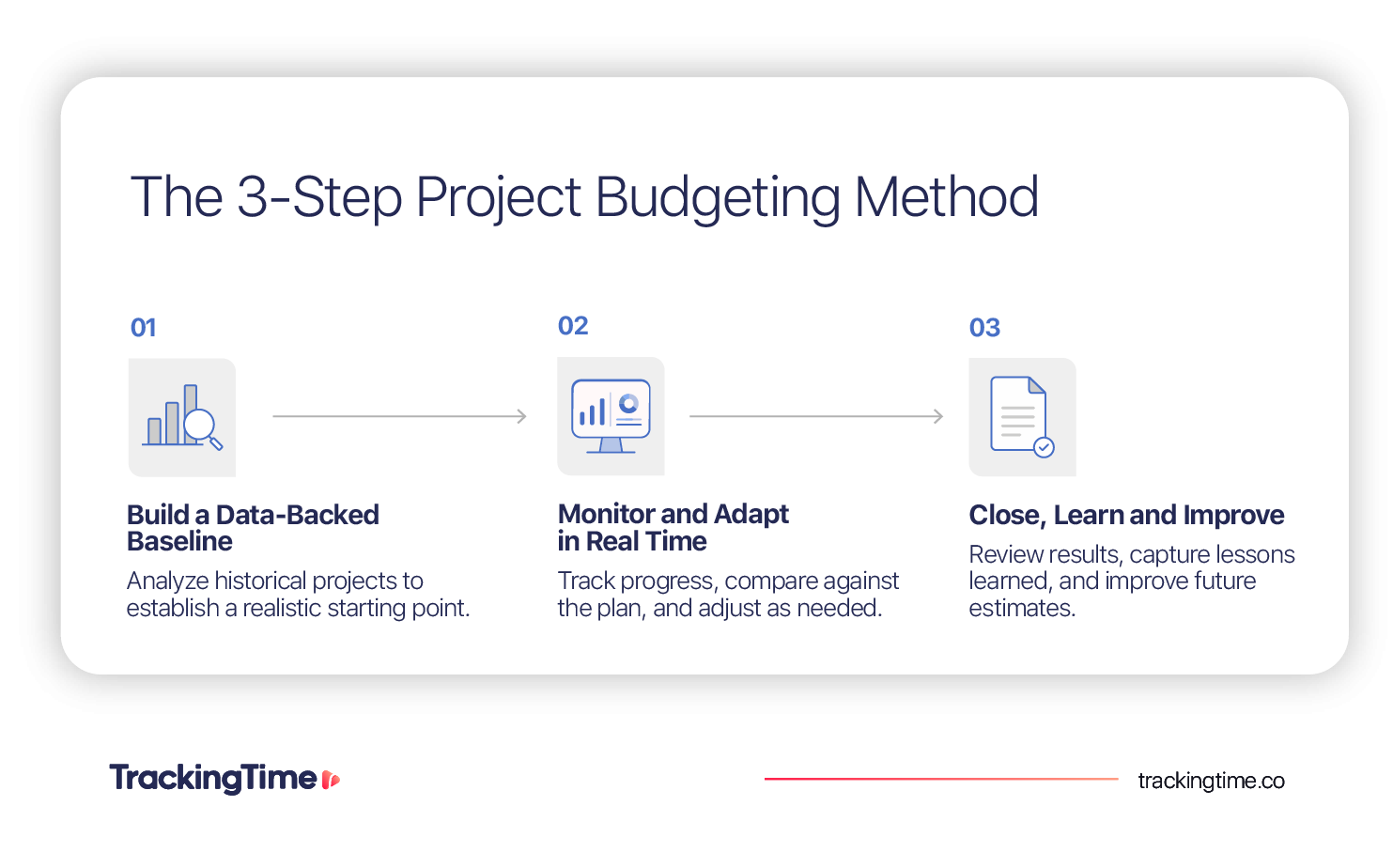

Here’s our 3-step method to build more accurate project budgets.

Step 1: Run a Historical Audit Before Estimating
Before creating a new project budget, review the three most recent comparable projects to establish a stronger baseline for time estimation. The goal is to replace memory-based assumptions with evidence about how the team delivers similar work.
Extract:
- Total logged hours
- Hours by project phase
- Hours by task
- Hours by team member or role
- Billable versus non-billable hours
- Time spent on revisions and client communication
- Unplanned work
- Initial estimate
- Final budget variance
Do not choose comparable projects based only on the service name. Two website redesigns, campaigns, or consulting engagements may require very different levels of effort.
Compare factors such as:
- Scope
- Complexity
- Team seniority
- Number of stakeholders
- Review rounds
- Client maturity
- Timeline
- Integrations or external dependencies

Comparing the same phases across three similar projects reveals the typical number of hours each category consumes. These ranges provide an evidence-based baseline for planning, production, project management, revisions, and QA before adjusting the estimate for the specific conditions of the new project.

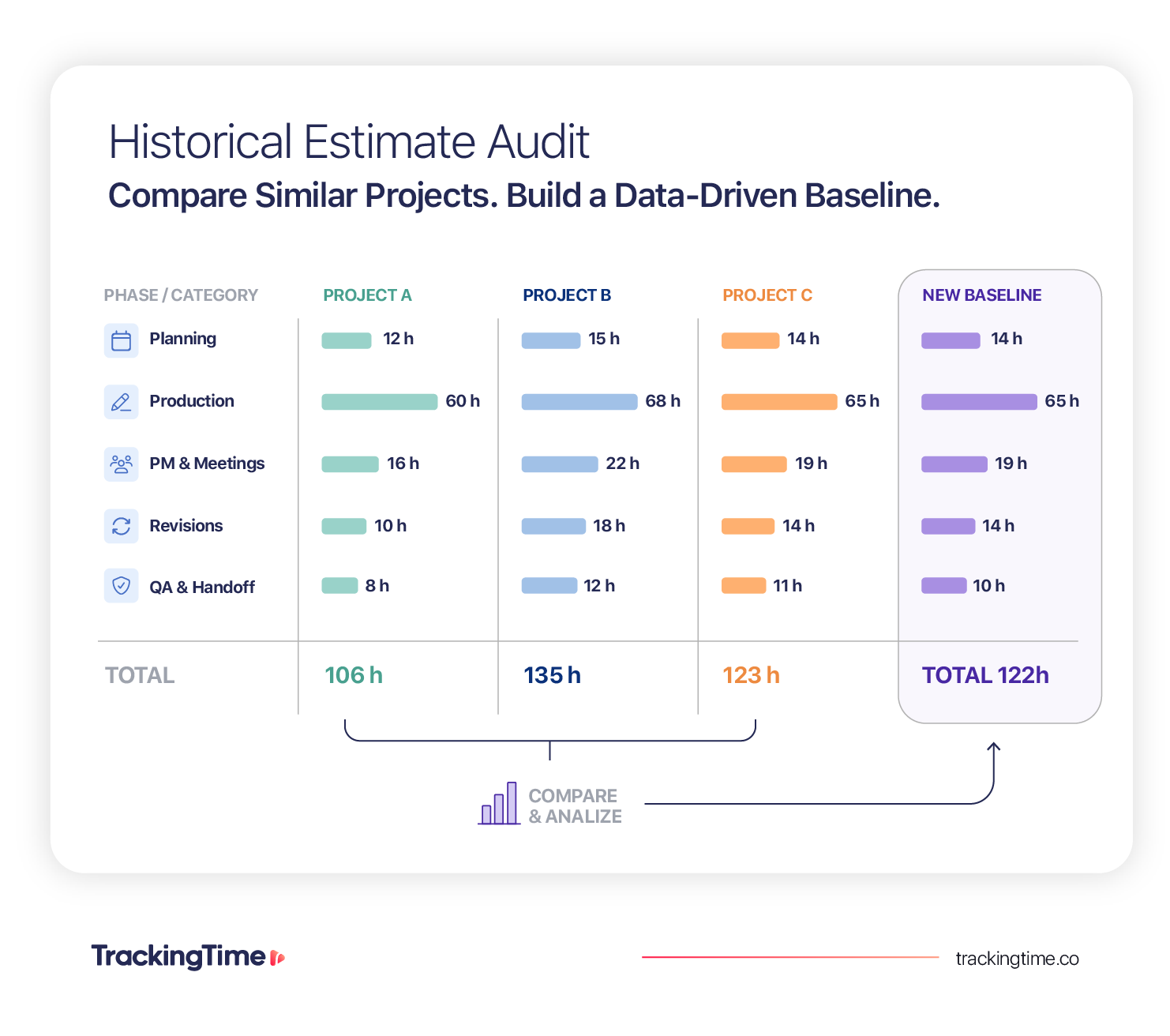

Historical Estimate Audit
According to a Project Management Institute (PMI) research cited by Deltek, organizations that use project benchmarking are 20% more likely to complete projects on time and within budget. For agencies, this can include comparing new estimates with the actual hours and performance of similar completed projects.
The new baseline should not be a blind average. Use medians, realistic ranges, and documented adjustments for differences in complexity, team composition, or client requirements.
Step 2: Track Burn Rate Against Delivery Progress
Once the project begins, review budget consumption every week and compare it with actual delivery progress. Monitoring logged hours alone is not enough; managers need to see whether the project is using its available budget at the same pace that work is being completed.
Track at least:
- Budgeted hours
- Actual logged hours
- Remaining hours
- Percentage of timeline elapsed
- Percentage of scope completed
- Forecasted hours at completion
Hours Burn Rate = Actual Logged Hours ÷ Estimated Hours × 100
Enter estimated and actual hours above to calculate your hours burn rate.
For example:
- Budget: 200 hours
- Logged: 130 hours
- Budget consumed: 65%
- Timeline elapsed: 50%
- Scope completed: 45%
The project has consumed 65% of its hour budget while completing only 45% of the scope. This indicates that the team is using hours faster than it is completing the work.
Suggested Operational Triggers
| Status | Signal | Recommended Action |
|---|---|---|
| Healthy | Budget consumption tracks delivery progress | Continue monitoring |
| Watch | Consumption is 10–15 percentage points ahead of progress | Review tasks and remaining scope |
| At risk | Consumption is 15–25 percentage points ahead | Reforecast and adjust staffing or scope |
| Critical | Consumption is more than 25 percentage points ahead | Escalate and agree on corrective action |
These thresholds are practical management triggers, not universal industry benchmarks. Teams should adjust them based on project length, delivery model, risk level, and historical variance.
Step 3: Create a Post-Mortem Feedback Loop
At project close, turn final delivery data into structured input for the next budget. The goal is to update the assumptions, templates, and thresholds used for future estimates.
Review questions such as:
- Which phases exceeded their estimates?
- Which tasks were missing from the original budget?
- Did the planned role mix change during delivery?
- How many revision cycles occurred?
- What client communication was not anticipated?
- Which work was non-billable?
- Which assumptions proved inaccurate?
- What should change in the baseline template?
Each post-mortem should produce concrete updates to:
- Task templates
- Baseline hours
- Role allocation
- Revision allowances
- Contingency
- Scope assumptions
- Warning thresholds
Industry Benchmark
Project overruns remain a persistent problem across professional services.
According to SPI Research’s 2025 Professional Services Maturity™ Benchmark Report, the average project overrun increased from 9.6% in 2023 to 11.3% in 2024, indicating that many firms still struggle to keep projects aligned with their original budgets.
This benchmark reinforces the need to monitor estimated and actual hours throughout delivery. Historical data can improve the baseline, while active budget tracking helps project managers detect variances early enough to adjust scope, staffing, and client expectations.
What the Industry Benchmark Shows
The benchmarks above point to the same conclusion. PMI research cited by Deltek found that organizations using project benchmarking are 20% more likely to finish on time and within budget, while SPI Research reports that average project overruns climbed from 9.6% to 11.3% between 2023 and 2024 for firms that don’t build estimates from historical performance data. The gap between those outcomes is exactly what a continuous, data-driven budgeting workflow is designed to close.
How TrackingTime Helps Teams Build More Accurate Project Budgets
TrackingTime helps agencies connect historical project data, live-logged hours, and budget monitoring into a single workflow. Instead of estimating from intuition and checking performance only after delivery, managers can use past project records to build stronger baselines and track budget consumption while there is still time to act.
Key features for agencies include:
- Historical Timesheets and Reports
Review completed projects by client, project, task, user, date, or custom field to understand how many hours similar work actually required. Saved reports also make it easier to repeat the same analysis across future projects. - Project and Task Time Estimates
Set expected hours at project and task level, then compare them with actual logged time as work progresses. This creates a direct link between the original budget and the effort being consumed during delivery. - Project Reports
See worked versus estimated time, task-level breakdowns, due dates, rates, and costs in one view. Managers can identify which phases or team members are driving variance rather than relying solely on the final project total. - Pace Reports
Monitor how quickly teams are consuming the available hour budget relative to the project timeline. This helps managers identify projects that are moving toward an overrun before the budget is exhausted. - Rates, Costs, and Billable Data
Connect logged hours with billable status, project rates, task rates, and internal team costs. This shows how hour variance can affect delivery cost and project margin without requiring a separate financial spreadsheet.
Together, these features create a continuous budgeting workflow: use historical logs to estimate, compare planned and actual hours during delivery, identify risk through live reports, and preserve final project data to improve the next budget.
⏱ Improve Your Project Budgeting With TrackingTime for Agencies
Connect historical project data, live-logged hours, and budget monitoring into a single workflow. TrackingTime for Agencies helps teams build more reliable estimates, detect budget risk earlier, and improve each new project with data from completed work.
Common Project Budgeting Mistakes
Even teams with detailed project plans can repeat the same budgeting errors from one engagement to the next. These mistakes weaken estimation accuracy, hide early warning signs, and make it harder to improve future project budgets.
- Copying the previous proposal without reviewing actual hours
Reusing an old estimate preserves the assumptions from the last project, including any hidden overruns or omitted work. - Estimating only client-facing deliverables
Budgets become incomplete when they exclude meetings, project management, reviews, QA, handoffs, and internal coordination. - Using the same baseline for every project
Similar services can require very different levels of effort depending on complexity, stakeholders, timelines, and team composition. - Tracking only the total budget
A project may appear healthy overall while one phase or task category is already consuming far more hours than planned. - Waiting until month-end to review consumption
Delayed reviews reveal what happened but leave little time to adjust scope, staffing, or delivery priorities. - Ignoring non-billable project work
Internal coordination, rework, and support still consume capacity and should be reflected in project estimates and variance analysis. - Completing post-mortems without updating templates
Lessons from completed projects have no practical value unless they change baseline hours, task structures, assumptions, or warning thresholds.
💡 Fixed-fee projects amplify estimation errors
When revenue is fixed, every unplanned hour reduces margin directly. Even a small forecasting error can become costly when it repeats across multiple projects.
Turn Project Budgeting Into a Continuous Learning System
Accurate project budgeting depends on more than a strong initial estimate. Reliable estimates need historical reference points, active budgets need live visibility into logged hours, and completed projects need to improve the next planning cycle.
When teams connect these three stages, project budgeting becomes a continuous learning system. Historical data strengthens time estimation, real-time monitoring surfaces budget risk during delivery, and post-project analysis improves the next baseline.
⏱ Try TrackingTime to improve your project budgeting
TrackingTime helps teams compare estimated and logged hours, monitor budget pace during execution, and preserve historical project data for more accurate future planning.
Frequently Asked Questions About Project Budgeting
What causes project budgeting failures?
Project budgeting failures usually result from intuition-based estimates, incomplete scopes, missing historical data, and delayed monitoring. Budgets also fail when recurring work such as meetings, revisions, QA, and project management is excluded from the original estimate.
Why do project estimates mismatch real hours?
Project estimates mismatch real hours when the estimate reflects only planned deliverables, while logged hours capture all the work required to complete them. Revisions, coordination, client communication, QA, handoffs, and rework often explain the difference.
How do you track budget variance?
Track budget variance by subtracting actual logged hours from estimated hours. A negative result means the project exceeded its hour budget. Calculate variance for the full project and for individual phases or tasks to identify where the estimation error occurred.
What is a project budget burn rate?
A project budget burn rate shows how quickly a project is consuming its estimated hours or costs over time. Comparing budget consumption with timeline and scope completion helps managers detect whether the project is using resources faster than it is delivering work.
How many past projects should you use for time estimation?
Use at least three genuinely comparable completed projects when possible. Compare scope, complexity, team composition, revision rounds, stakeholders, and delivery conditions rather than selecting projects only because they share the same service label.
How often should project budgets be reviewed?
Active project budgets should normally be reviewed weekly and at important milestones. Higher-risk or shorter projects may require more frequent checks. The objective is to identify variance while managers can still adjust scope, staffing, sequencing, or client expectations.
Can time tracking improve project estimates?
Yes. Historical time tracking shows how many hours similar projects actually required and where those hours were spent. It does not eliminate uncertainty, but it provides a stronger baseline than memory or intuition alone.
What should be included in a project time estimate?
A project time estimate should include production work, planning, project management, meetings, internal reviews, client feedback, revision rounds, QA, documentation, handoffs, and contingency. Any recurring activity visible in historical project logs should be considered.
